建筑物沉降观测的精度及观测频率
建筑物沉降观测的精度及观测频率
摘要:近年建起了一大批高楼大厦,这实是人们利用仅有空间的一个好办法。
随着高层建筑和现代化厂房的迅速发展,人们将面临着一个必须解决的问题——建筑物的沉降问题。
因为建筑物的沉降变形情况如何,直接关系到建筑物的安全使用,尤其是高层建筑。
故为了建筑物的安全使用,在建筑物的施工和运行管理期间需要进行建筑物的沉降观测,保证建筑工程质量和安全生产,同时也为今后建筑物的结构和地基基础合理的设计,积累资料。
本文主要论述沉降观测的精度和沉降观测的频率。
关键词:沉降观测;精度;观测频率
Abstract: In recent years, built a large number of high-rise buildings, this is actually a good way for people to use only the space. With the rapid development of high-rise buildings and modern plant, it will be faced with a need to solve the problem - building subsidence problems. Buildings settlement deformation is directly related to the safe use of the building, especially in high-rise buildings. It is for the safe use of the building, in the building’s construction and during the operation and managemen t of the need for building settlement observation to ensure the production of quality and safety of construction works, but also for future rational design of the structure of the building and the foundation, the accumulated data . This paper discusses the settlement observation precision and frequency of settlement observation.Keywords: settlement observation; accuracy; observation frequency
一、沉降的原因
一般来说,建筑物的沉降主要由两个方面的原因引起的,一是自然条件及其变化,即建筑物地基的工程地质、水文地质、土壤的物理性质、大气温度等。
如基础的地质条件不同,有的稳定,有的不稳定,会引起建筑物的不均匀沉降,使其发生倾斜。
另一个原因与建筑物的本身有关,即建筑物本身的荷重、建筑物的结构等。
二、沉降观测内容和目的
建筑物的沉降是地基、基础和上层结构共同作用的结果。
沉降观测是其观测的主要内容,通过观测来分析相对沉降是否有差异,以监视建筑物的安全。
工程建筑物的变形按其类型分:可以分为静态变形和动态变形。
静态变形通常是指变形观测的结果只表示在某一期间内的变形,也就是说,它只是时间的函数;动态变形是指在外力影响下而产生的变形,故它是以外力为函数来表示系统
对于时间的变化,其观测结果是表示建筑物在某个时刻的瞬间变形。
根据建筑物沉降的性质可分为两类:
均匀沉降:当受压软土分布位置和厚度相同,基础作用条件近似时,沉降量虽大,但建筑物不会出现倾斜和裂缝,此种沉降属于均匀沉降,对建筑物的危害不大。
不均匀沉降:当基础受压层土质不同、承压性能不同,或由于建筑设计不合理及施工不当等原因都会发生不均匀沉降,轻者建筑物会产生倾斜或裂缝,严重的会造成建筑物的倒塌。
三、沉降观测的精度
《建筑物变形测量规程》第3.2.1条规定:“相对沉降、局部地基沉降及膨胀土地基变形等的观测误差,均不应超过允许变形值的1/20”。
由于威胁建筑物安全的主要是基础沉降不均匀造成建筑物倾斜或剪断。
如果仅作为反映变形值不超过某一允许的数值而确保建筑物的安全的话,采用允许变形值的1/10是可以的。
1、按允许变形值求观测中误差:
建筑物的允许变形值大多是由设计单位提供的,一般可直接应用。
设允许变形值为δ容,观测中误差m=∆容/10的原则。
假定某建筑物的高为H=30m,允许倾斜角α=4%。
当为了监视建筑物安全时,则顶部容许偏移量按下式计算:
δ容=α•H=(4/1000)•30=120mm
倾斜中误差:m倾=δ容•(1/20)•(1/3)=±2mm(根据使用仪器和观测目的)相对位移来说,由于倾斜是沉降和位移共同影响的结果,所以:
m移= m倾/=1.43mm
2、精度指标
根据我国工程测量单位的时间经验认为:“沉降量观测的最大误差,应为差异沉降最大容许值的1/10”,而差异沉降最大容许值按下列式计算:
δ最大=2•L/1000
式中L----两相邻沉降点的间距
沉降量的观测中误差一般掌握在1mm左右
例如某12层楼房,两相邻沉降点之间的间距L=8m,则有:
差异沉降最大容许值:δ最大=8 ╳(2/1000)=16mm
差异沉降最大观测中误差:m限=δ最大╳(1/10)=±1.6mm
差异沉降量观测中误差:m沉= m限╳(1/2)=±0.8mm
四、沉降观测的频率
观测的频率取决于变形值的大小和变形速度以及观测的目的。
通常要求观测的次数既能反映出变化的过程,又不能遗漏变化的时刻。
关于沉降观测的频率, 《建筑物变形测量规程》(JGJT8—97)规定:沉降观测的周期和观测时间,可按下列要求并结合具体情况确定:
建筑物施工阶段的观测,应随施工进度及时进行。
一般建筑,可在基础完工后或地下室砌完后开始观测,大型、高层建筑,可在基础垫层或基础底部完成后开始观测。
观测次数与间隔时间应视地基与加荷情况而定。
民用建筑可每加高1-5层观测一次;工业建筑可按不同施工阶段(如回填基坑、安装柱子和屋架、砌筑墙体、设备安装)分别进行观测。
如建筑物均匀增高,应至少在增加荷载的25%。
50%、75%和100%时各测一次。
施工过程中如暂时停工,在停工时及重新开工时应各观测一次。
停工期间,可每隔2-3个月观测一次。
规范中说:“民用建筑可每加高1-5层观测一次”,具体操作时到底多少层观测一次,才能真正做到既能反映建筑物的变形情况又能做到最省时省力呢?这就摆在了我们搞具体工程者的面前。
而各种文献的说法又各有差异。
规范特别强调了“观测次数与间隔时间应视地基与加荷情况而定。
”那么我们就有必要探讨“如何做才能做到既能反映建筑物的沉降过程又最省时省力?”首先,让我们来分析建筑物沉降的过程。
其过程可大体分为四个阶段。
a.施工阶段。
此阶段下沉量最大,约占总下沉量的70%左右,年下沉量可达20-70mm。
b.下沉速度减缓阶段。
年下沉量约为2mm。
c.平稳下沉阶段。
年下沉量约为1-2mm。
d.稳定阶段。
通过以上对建筑物下沉过程的分析,我们就可以根据建筑物沉降的规律来确定建筑物沉降观测的频率。
在施工阶段,当埋设的观测点稳固后即进行第一次观
测,第二次在增加一层或较大荷载(浇灌基础。
回填土等)时进行观测。
第三次的观测时间要根据第二次的沉降量来定(因沉降量除了与荷载有关外,还与工程性质、地基土质情况有关),若第二次所测得的沉降量不是很小,则以后就以每增加一层观测一次;若第二次测得的沉降量很小,则第三次就以每增加二层观测一次,若此时沉降量不是很小,则以后就以每增加二层观测一次;如果每增加二层观测一次的沉降量仍很小,以后可以每增加三层观测一次,甚至四层或五层观测一次,具体视沉降量大小而定。
如中途停工时间较长,应在停工的前后进行观测。
停工期间隔2-3个月观测一次。
如在施工过程中遇下列。
情况都要进行观测:1)基础附近地面荷载突然增加很大;2)建筑物周围大量积水或暴雨:3)建筑物周围大量挖方等。
另外,当建筑物发生大量沉降或严重裂缝时,应及时进行逐日或几天一次的连续观测。
竣工后,按沉降速度参照表所列观测周期观测,直到每日沉降量≤0.01mm为止。
这样做,我们既能做到尽量省时省力,又能恰到好处地反映建筑物的沉降过程。
五、结束语
城市中高层建筑物的沉降观测,从沉降观测的组织工作,到布网方案的设计,到网点的布设,在到仪器选择,外业采集数据,及内业数据的处理,都是沉降观测工作中很重要的环节,本文讨论的沉降观测的精度和沉降观测的频率对于制定沉降观测系统更是非常重要的。
参考文献一览表
1、北京测绘处编:>,测绘出版社,1981年
2、(苏)B.H 甘申等:>,测绘出版社,1986年
3、李青岳等:>,测绘出版社,1995年
4、>,中国建筑工业出版社,1998
5、>,中国计划出版社,2001年。
建筑物沉降观测测量记录要求

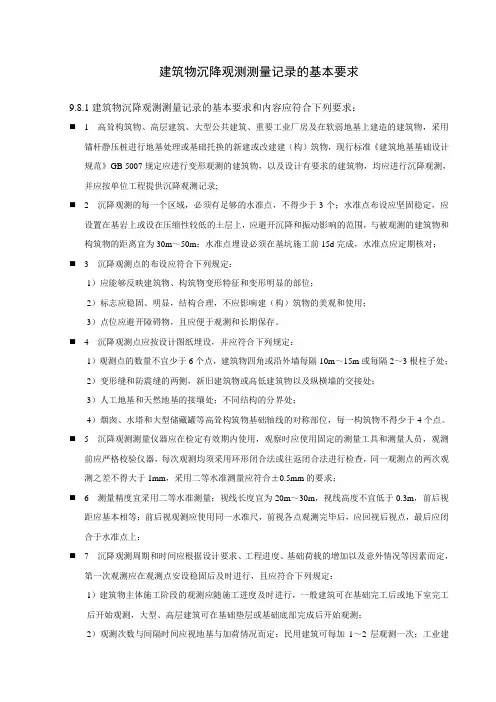

建筑物沉降观测测量记录的基本要求9.8.1建筑物沉降观测测量记录的基本要求和内容应符合下列要求:⏹ 1 高耸构筑物、高层建筑、大型公共建筑、重要工业厂房及在软弱地基上建造的建筑物,采用锚杆静压桩进行地基处理或基础托换的新建或改建建(构)筑物,现行标准《建筑地基基础设计规范》GB 5007规定应进行变形观测的建筑物,以及设计有要求的建筑物,均应进行沉降观测,并应按单位工程提供沉降观测记录;⏹ 2 沉降观测的每一个区域,必须有足够的水准点,不得少于3个;水准点布设应坚固稳定,应设置在基岩上或设在压缩性较低的土层上,应避开沉降和振动影响的范围,与被观测的建筑物和构筑物的距离宜为30m~50m;水准点埋设必须在基坑施工前15d完成,水准点应定期核对;⏹ 3 沉降观测点的布设应符合下列规定:1)应能够反映建筑物、构筑物变形特征和变形明显的部位;2)标志应稳固、明显,结构合理,不应影响建(构)筑物的美观和使用;3)点位应避开障碍物,且应便于观测和长期保存。
⏹ 4 沉降观测点应按设计图纸埋设,并应符合下列规定:1)观测点的数量不宜少于6个点,建筑物四角或沿外墙每隔10m~15m或每隔2~3根柱子处;2)变形缝和防震缝的两侧,新旧建筑物或高低建筑物以及纵横墙的交接处;3)人工地基和天然地基的接壤处;不同结构的分界处;4)烟囱、水塔和大型储藏罐等高耸构筑物基础轴线的对称部位,每一构筑物不得少于4个点。
⏹ 5 沉降观测测量仪器应在检定有效期内使用,观察时应使用固定的测量工具和测量人员,观测前应严格校验仪器,每次观测均须采用环形闭合法或往返闭合法进行检查,同一观测点的两次观测之差不得大于1mm,采用二等水准测量应符合±0.5mm的要求;⏹ 6 测量精度宜采用二等水准测量;视线长度宜为20m~30m,视线高度不宜低于0.3m,前后视距应基本相等;前后视观测应使用同一水准尺,前视各点观测完毕后,应回视后视点,最后应闭合于水准点上;⏹7 沉降观测周期和时间应根据设计要求、工程进度、基础荷载的增加以及意外情况等因素而定,第一次观测应在观测点安设稳固后及时进行,且应符合下列规定:1)建筑物主体施工阶段的观测应随施工进度及时进行,一般建筑可在基础完工后或地下室完工后开始观测,大型、高层建筑可在基础垫层或基础底部完成后开始观测;2)观测次数与间隔时间应视地基与加荷情况而定;民用建筑可每加1~2层观测一次;工业建筑可按不同施工阶段分别进行观测,若建筑物均匀增高,应至少增加荷载的25%、50%、75%和100%时各测1次;烟囱等构筑物每增加15m观测1次;采用锚杆静压桩在压桩前、后应各观测1次;3)施工过程中如暂时停工时间较长,在停工时复工前应各观测1次,停工期间,可据实际情况每隔2~3个月观测1次,整个施工期间的观测不得少于4次;4)在观测过程中,如有基础附近地面荷载突然增减、基础四周大量积水、长时间连续降雨等情况,均应增加观测次数;当建筑物突然发生大量沉降、不均匀沉降或严重裂缝时,应增加观测次数,做好记录;5)建筑使用阶段的观测次数,应按设计要求,或视地基土类型和沉降速度大小确定;⏹8 沉降观测应作好记录,并及时整理和妥善保管记录,观测工作结束后,应提交下列成果:1)沉降观测记录;2)沉降观测点位分布图及各周期沉降展开图;3)建筑物沉降曲线图和沉降观测分析记录。
建筑沉降观测规范
建筑学与地理信息科学的结合,实现更精准的沉降观测。
引入大数据和人工智能技术,对沉降观测数据进行深度挖掘和分析,提高预测精度。
建筑结构工程与统计学理论的交叉融合,为沉降观测提供更可靠的依据。
借助物联网技术,实现多源数据的实时采集和传输,提高观测效率。
技术应用:利用物联网、云计算、大数据等技术手段
未来发展:推广普及信息化管理平台,促进沉降观测行业的可持续发展
目的:实现沉降观测数据的实时采集、传输、处理和监测
优势:提高观测效率和精度,降低人工成本和误差
汇报人:韵
发展趋势:随着技术的不断进步,智能化观测技术将更加成熟和普及。
定义:利用先进的信息技术,实现自动化、智能化的沉降观测。
优势:提高观测精度和效率,减少人为误差和观测成本。
添加标题
添加标题
添加标题
添加标题
数据分析技术不断进步,如人工智能、大数据等
沉降观测数据要求高精度、高频率
数据处理软件功能强大,可实现自动化、智能化处理
韵,a click to unlimited possibilities
汇报人:韵
CONTENTS
添加目录标题
沉降观测的目的和意义
沉降观测的基本要求
沉降观测的程序
沉降观测的注意事项
沉降观测的发展趋势
PART ONE
PART TWO
沉降观测的目的是为了及时发现建筑物的不均匀沉降,确保建筑物的安全。
及时发现地基问题,避免因地基不均匀沉降导致的结构破坏
为建筑物的安全使用提供保障
PART THREE
观测点应设置在能反映建筑物沉降变化的特征点上,如墙角、承重柱、纵横墙交接处等。
既有建筑沉降观测方案
既有建筑沉降观测方案既有建筑沉降观测方案引言:在城市建设与发展的过程中,既有建筑的稳定性与安全性一直是我们非常关注的问题。
而建筑沉降是既有建筑稳定性的一个重要指标,在城市建设中具有重要的意义。
因此,为了准确、及时地掌握既有建筑的沉降情况,需要制定一套完善的观测方案。
本文将就既有建筑沉降观测方案进行详细的阐述,以期为工程师以及相关从业人员提供参考和指导。
一、研究目的:1.掌握既有建筑的沉降情况,为建筑的稳定性评估提供依据。
2.提前发现既有建筑的沉降问题,及时采取必要的修复和加固措施。
3.为相关城市规划和设计提供参考数据。
二、观测内容:1.既有建筑的表面沉降。
2.地基沉降。
3.建筑物内部的变形情况。
三、观测方法:1.表面沉降观测:采用高精度测量仪器对既有建筑表面进行多次测量,利用观测数据计算既有建筑的沉降量和速率。
2.地基沉降观测:通过地下水位观测井、沉降观测井等设备,测量地基的沉降情况。
3.建筑物内部变形观测:通过安装应变计和位移计等仪器,监测建筑物内部的变形情况。
四、观测频率:1.表面沉降观测:建议每个季度进行一次观测,并根据观测结果判定是否增加观测次数。
2.地基沉降观测:建议每月进行一次观测,以及在重大工程施工期间增加观测频率。
3.建筑物内部变形观测:视建筑物的重要程度和使用情况而定,一般建议每季度或每年进行一次观测。
五、数据处理与分析:1.表面沉降观测数据处理:采用专业软件对观测数据进行处理,得到沉降量和速率图表,并进行趋势分析,以判断是否存在异常沉降情况。
2.地基沉降观测数据处理:将观测数据与建筑结构分析结果进行对比,计算沉降量和速率,提供给工程师进行稳定性评估。
3.建筑物内部变形观测数据处理:根据观测数据计算出变形量和速率,并与设计值进行对比,判断变形是否符合设计要求。
六、报告撰写与汇总:1.观测数据和分析结果汇总:对观测数据进行整理,绘制沉降分布图和沉降速率图,编写观测报告。
2.报告撰写与汇总:编写观测报告,包括观测目的、方法、频率、数据处理与分析、结论等内容,并将观测报告交给相关利益相关方。
建筑物沉降观测的精度及观测频率
建筑物沉降观测的精度及观测频率作者:高鹏来源:《城市建设理论研究》2012年第29期摘要:近年建起了一大批高楼大厦,这实是人们利用仅有空间的一个好办法。
随着高层建筑和现代化厂房的迅速发展,人们将面临着一个必须解决的问题——建筑物的沉降问题。
因为建筑物的沉降变形情况如何,直接关系到建筑物的安全使用,尤其是高层建筑。
故为了建筑物的安全使用,在建筑物的施工和运行管理期间需要进行建筑物的沉降观测,保证建筑工程质量和安全生产,同时也为今后建筑物的结构和地基基础合理的设计,积累资料。
本文主要论述沉降观测的精度和沉降观测的频率。
关键词:沉降观测;精度;观测频率Abstract: In recent years, built a large number of high-rise buildings, this is actually a good way for people to use only the space. With the rapid development of high-rise buildings and modern plant, it will be faced with a need to solve the problem - building subsidence problems. Buildings settlement deformation is directly related to the safe use of the building, especially in high-rise buildings. It is for the safe use of the building, in the building's construction and during the operation and management of the need for building settlement observation to ensure the production of quality and safety of construction works, but also for future rational design of the structure of the building and the foundation, the accumulated data . This paper discusses the settlement observation precision and frequency of settlement observation.Keywords: settlement observation; accuracy; observation frequency中图分类号:P185.11 文献标识码:A 文章编号:2095-2104(2012)一、沉降的原因一般来说,建筑物的沉降主要由两个方面的原因引起的,一是自然条件及其变化,即建筑物地基的工程地质、水文地质、土壤的物理性质、大气温度等。
建筑物的沉降观测
建筑物的沉降观测1)水准点的设置沉降观测应根据稳定性良好的水准点进行,水准点应考虑永久使用,为了便于检查核对,专用水准点埋设不少于三个,埋设地点必须稳定不变,防止施工机具、车辆碰压。
2)仪器选择本工程沉降观测使用精密水准仪(DS1)及配套的水准尺。
3)观测依据及精度要求(1)依据《工程测量规范》GB50026-93、《建筑变形测量规程》JGJ/T8-97二级的要求。
(2)精度要求:JGJ/T8-97二级要求。
4)沉降观测点的布置:沉降观测点的布置应符合设计要求,设计未规定时,按下列原则设置:(1)建筑物的四角、大转角处及沿外墙每10-15m设置一处;(2)建筑物和沉降缝两侧,不同结构的分界处。
5)沉降观测的标志:根据本建筑的结构类型和建筑材料,用隐蔽或标志,如图:6)沉降观测的周期及观测时间(1)建筑物施工阶段的观测,应随施工进度及时进行,一般每增加一层观测一次。
当建筑物发生较大沉降或不均匀沉降时,应立即向工程技术负责人汇报,并立即进行每日或数日一次连续值班观测。
(2)建筑物使用阶段的观测次数,应视地基类型和沉降速度大小而定。
一般情况下,第一年观测3-4次,第二年观测2-3次,第三年后每年1次,直至稳定而止。
(3)沉降是否进入稳定阶段,应由沉降与时间关系曲线判定。
若沉降速度小于0.01-0.04mm/d,可认为已进入稳定阶段。
7)沉降观测结束后,应及时整理观测资料,妥善保存,作为该工程技术档案资料的一部分,观测成果应包括:(1)沉降观测成果表;(2)沉降观测点位分布图及各周期沉降展开图;(3)v-t-s9(沉降速度、时间、沉降量)曲线图;(4)沉降观测分析报告。
沉降观测规范
沉降观测标准一、沉降观测的根本要求1、仪器设备、人员素质的要求根据沉降观测精度要求高的特点,为能准确地反映出建(构)筑物在不断加荷下的沉降情况,一般规定测量的误差应小于变形值的1/10—1/20,为此要求沉降观测应使用精细水准仪(S1或S05级),水准尺也应使用受环境及温差变化影响小的高精度铟合金水准尺。
在不具备铟合金水准尺的情况下,使用一般塔尺尽量使用第一段标尺。
作业人员必须承受专业学习及技能培训,纯熟掌握仪器的操作规程,熟悉测量理论,能针对不同工程特点、详细情况采用不同的观测方法及观测程序,对施行过程中出现的问题能分析^p 原因并正确运用误差理论进展平差计算,按时、快速、准确地完成每次观测任务。
2、观测时间的要求建(构)筑物的沉降观测对时间有严格的限制条件,特别是首次观测必须按时进展,其他各阶段的复测,根据工程进展情况必须定时进展,不得漏测或补测。
只有这样,才能得到准确的沉降情况或规律。
相邻的两次时间间隔称为一个观测周期,一般高层建筑物的沉降观测按一定的时间段为一观测周期(如:30天/次)或按建筑物的加荷情况每升高一层(或数层)为一观测周期,无论采取何种方式都必须按施测方案中规定的观测周期准时进展。
3、观测点的要求为了可以反映出建(构)筑物的准确沉降情况,沉降观测点要埋设在最能反映沉降特征且便于观测的位置。
一般要求建筑物上设置的沉降观测点纵横向要对称,且相邻点之间间距以15-30米为宜,均匀地分布在建筑物的周围。
通常情况下,建筑物设计图纸上有专门的沉降观测点布置图。
此外,埋设的沉降观测点要符合各施工阶段的观测要求,特别要考虑到装修装饰阶段,是否会因墙或柱饰面施工而破坏或掩盖住观测点,不能连续观测而失去观测意义。
4、沉降观测自始至终要遵循“五定”原那么“五定”即沉降观测根据的基准点、工作基点和被观测物的沉降观测点,点位要稳定;所用仪器、设备要稳定;观测人员要稳定;观测时的环境条件根本一致;观测道路、镜位、程序和方法要固定。
简述建筑物沉降观测的方法和精度要求
简述建筑物沉降观测的方法和精度要求下载提示:该文档是本店铺精心编制而成的,希望大家下载后,能够帮助大家解决实际问题。
文档下载后可定制修改,请根据实际需要进行调整和使用,谢谢!本店铺为大家提供各种类型的实用资料,如教育随笔、日记赏析、句子摘抄、古诗大全、经典美文、话题作文、工作总结、词语解析、文案摘录、其他资料等等,想了解不同资料格式和写法,敬请关注!Download tips: This document is carefully compiled by this editor. I hope that after you download it, it can help you solve practical problems. The document can be customized and modified after downloading, please adjust and use it according to actual needs, thank you! In addition, this shop provides you with various types of practical materials, such as educational essays, diary appreciation, sentence excerpts, ancient poems, classic articles, topic composition, work summary, word parsing, copy excerpts, other materials and so on, want to know different data formats and writing methods, please pay attention!建筑物沉降观测方法与精度要求1. 引言建筑物的沉降观测是建筑工程中至关重要的一环,它旨在监测建筑物在使用过程中是否存在沉降现象,及时发现并采取措施以确保建筑物的安全运行。
建筑物的沉降观测综述
建筑物的沉降观测综述[摘要]本文论述建筑物沉降观测方法、成果整理和成果分析。
[关键词]沉降沉降观测沉降曲线图在建筑物的施工和初期使用阶段,建筑物本身的荷载和外力的作用会使建筑物发生一定的沉降和变形,而且可能导致周边临近的建筑物发生沉降和变形。
为了保证建筑物的安全,保证人民生命财产免遭损失,有必要对建筑物和临近地区的不同位置进行高程观测,以便掌握沉降量变化的规律。
这便是建筑物沉降观测。
建筑物沉降观测是建筑测量的一个重要环节。
对于高层建筑、重要厂房的柱基以及主要设备基础、连续性生产和受震动较大的设备基础、工业炼钢高炉、高大的电视塔、人工加固的地基、回填土、地下水位较高或大孔土地基的建筑物应该进行系统的沉降观测。
建筑物沉降观测目前普遍采用水准测量的方法进行观测,此外,全站仪加反射片的沉降观测[1]、GPS沉降观测[2]方法在实际工程中都得到应用。
下文就建筑物沉降观测水准测量的方法、成果整理和成果分析三方面展开论述。
一、沉降观测的方法1. 水准点的布置水准点的布设,采用永久性的水准点布置要求布置,按照二、三等水准点标石规格埋设标志。
为了保证水准点的稳定性,要求水准点不应该少于3个,以组成水准点网,各个水准点之间互相校核。
水准点应该埋设在基础压力影响范围以及震动影响范围以外的安全地带,一般距离基坑开挖边线50米左右。
水准点应该离开铁路、公路、地下管线和滑坡地带至少5米的距离。
为了防止冰冻影响,水准点埋设深度至少要在冰冻线以下0.5米。
为了保证观测精度,水准点与观测点之间的距离不应该大于100米。
2. 观测点的布置进行沉降观测的建筑物观测点的布置与建筑物或设备基础的结构、大小、荷载和地质条件有关。
沉降观测点要埋设在最能反映沉降特征且便于观测的位置。
在民用建筑中,一般沿着建筑物的四周,每隔6~12米布置一个观测点,在房屋转角、沉降缝或伸缩缝的两侧、基础形式改变处及地质条件改变处也应该布设观测点。
当房屋宽度大于15米时,还应该在房屋内部纵轴线上和楼梯间布设观测点。
沉降观测仪标准
沉降观测仪标准一、概述沉降观测仪是一种用于测量建筑物、桥梁、路基等工程建筑物沉降量的仪器。
其原理是利用高精度传感器,通过测量建筑物表面的位移变化,计算出沉降量。
由于沉降观测对于保障建筑物的安全和使用寿命具有重要意义,因此沉降观测仪的标准也至关重要。
二、技术要求1. 精度要求沉降观测仪的精度要求应符合国家相关标准规定。
一般来说,其精度等级不应低于二级,即最大允许误差不超过±0.05mm。
同时,在观测过程中,应采取措施保证观测数据的稳定性和可靠性。
2. 传感器要求沉降观测仪所使用的传感器应具有高灵敏度、低零漂、高分辨率等特点,同时应具备防尘、防水、防震等性能,以保证在恶劣环境下正常工作。
3. 仪器稳定性要求沉降观测仪应具有稳定的性能,即在长时间连续观测过程中,其测量结果应保持一致。
此外,仪器还应具有故障自诊断功能,以便及时发现并处理故障。
4. 外观要求沉降观测仪的外观应简洁、美观,操作界面友好,方便用户使用。
同时,仪器应具有一定的防护措施,以避免在使用过程中受到损坏。
三、使用要求1. 观测点设置在进行沉降观测前,应根据工程实际情况选择合适的观测点位置,并确保观测点的牢固性和稳定性。
对于不同结构类型的建筑物,观测点的设置方法也应有所不同。
2. 观测周期与频率沉降观测的周期和频率应根据建筑物的特性和使用要求确定。
一般来说,在施工期间应每2-3天观测一次,而在使用期间则应每周观测一次。
在遇到特殊情况时,应根据需要增加观测次数。
3. 数据记录与分析沉降观测的数据应准确记录并进行分析。
通过分析数据的变化趋势,可以判断出建筑物的沉降量以及沉降速度是否正常。
同时,通过对数据的比较和分析,还可以为工程设计和施工提供参考依据。
四、质量保证体系要求1. 产品质量保证沉降观测仪的生产厂家应具备相应的生产资质和经验,并应建立完善的质量保证体系。
在产品出厂前,应对每一台仪器进行严格的检验和测试,确保其性能和质量符合标准要求。
建筑物的沉降观测标准
建筑物的沉降观测标准1、初测建(构)筑物的沉降观测对时间有严格的限制条件,特别是首次观测必须按时进行,否则整个观测得不到完整的观测意义。
初测应增加观测量,以提高初始值的可靠性。
2、施工阶段的沉降观测应依据施测方案随施工进度及时进行。
重要建筑,可在基础完工或地下室砌完后开始观测。
大型、高层建筑,可在基础垫层或基础底部完成后开始观测。
观测次数与时间应视地基与加荷情况而定。
民用建筑可每加高1~2层观测一次;工业建筑可按不同施工阶段(如回填基坑、安装柱子和屋架、砌筑墙体和设备安装等)分别进行观测。
如建筑物均匀增高,应至少在每增加荷载的25%时各测一次。
施工过程中如暂时停工,在停工时及重新开工时应各观测一次。
停工期间,可每隔2~3个月观测一次。
封顶后1~2月观测一次,竣工后观测周期,根据建筑物的稳定情况确定。
特别需要指出的是,,沉降速度≥2.0mm/d应停止施工,分析原因,采取措施。
沉降速度≥1.0mm/d应减缓加载速度并增加观测次数。
各个阶段的复测必须定时进行,不得漏测或补测,只有这样才能得到准确的沉降情况或规律。
3、建筑物使用阶段的观测观测次数应视地基土类型和沉降速度大小而定。
一般在第一年观测3~4次,第二年2~3次,第三年后每年一次,直至稳定为止。
观测的期限一般规定如下:砂土地基2年,膨胀土地基3年,粘土地基5年,软土地基10年。
若沉降速度小于0.01 mm/d ,根据沉降曲线分析,认为已经稳定,可以停止观测。
4、对于荷载突然增加,基础四周大量积水,长时间连续降水等情况,均应及时增加观测次数,当建筑物突然发生大量沉降,不均匀沉降或严重裂缝时,应立即逐日或2~3天一次的连续观测。
六、竣工验收标准《建筑物沉降观测方法》(DGJ32/J18-2006)第5.0.6条规定:对建(构)筑物进行竣工验收时,地基沉降变形观测值在没有相应的规范、设计要求时,可参照本条执行。
每周期观测后,应及时对观测资料进行整理,计算观测点的沉降量、沉降差,以及本周期平均沉降量和沉降速度。
